Homebuilding on Oregon Coast

by Paul F. Watson

The Dream: Splendid vistas on the Oregon coast attract many, but the challenges and expense of turning vistas into a finished home are daunting. Below, is a photographic record of one such home.

The Reality: The technical challenges and financial demands of such a project are not for the faint of heart. Good engineering, good management and excellent subcontractors with knowledge of local conditions are essential. On the Oregon Coast, the weather is key to a successful schedule. As with this project, delays which force concrete work past mid October make completion of the foundation problematic.

The Process: The process consists roughly of the following:

  1. Obtain Engineering, Geology Reports & Building Approvals
  2. Clear Land of trees in immediate building area
  3. Contour Land to facilitate drilling piers & building foundation
  4. Drill & Install Piers
  5. Build Foundation Beams & Backfill. Complete Verticle Concrete as Required
  6. Framing, windows, doors & decks
  7. Electrical Wiring, Plumbing & Mechanical
  8. Interior Work-insulation, sheet rock, kitchen & baths

Subcontracting Team: The project engaged several excellent subcontractors:

  1. Murphy's Payrole & Book Keeping Service out of Portland area
  2. Structural Engineering: Stricker Engineering from Garibaldi Oregon
  3. All Terrain Excavation (Spider Hoe: Eric Mauck from Boring Oregon)
  4. Boswell Excavation (Excavator: Rocky Boswell of Tillamook Oregon)
  5. PLI systems (Speciality Micropile Drilling & Installation from Hillsboro Oregon)
  6. Watson Coastal Enterprises (Foundation Construction with help of consultant James Gardner)
  7. Oregon Truss: Provided well designed, documented, quality trusses on schedule.

Progress to Date:

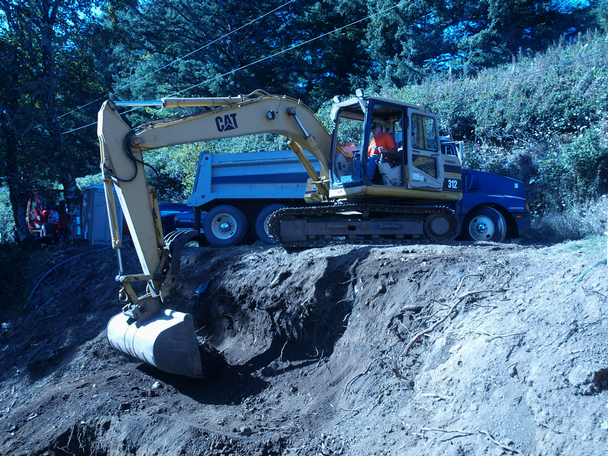

Clearing the Land requires team work. An experienced lumber man with a chain saw fells selected trees in place. The steep slopes require a spider hoe to dig up stumps and pass the timber up the hill. Finally, an escavator at the top takes timber from the spider hoe and loads it into a truck for disposal. For safety, steap slopes require an experienced team.

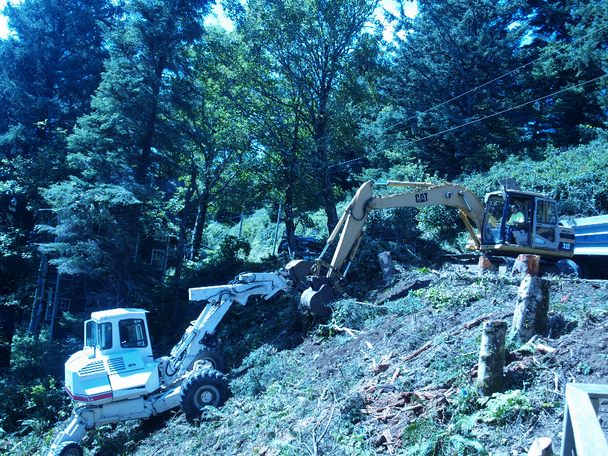

Teamwork Required for Safely Passing Logs from Spider Hoe Up the Hill

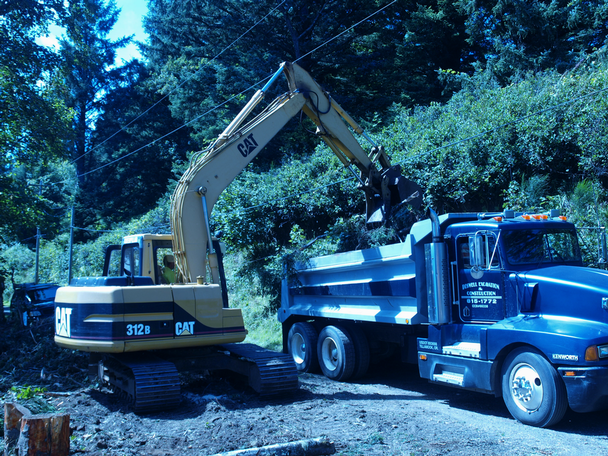

Rocky Boswell Loads Logs for Disposal

Contouring the Land relies on continued coordination of the Spider Hoe operator and the Excavator operator. This project utilized Eric Mauck and Rocky Boswell who have done many projects together. Smooth coordination in excavating and moving debris up the hill with few spoken words was a joy to watch.

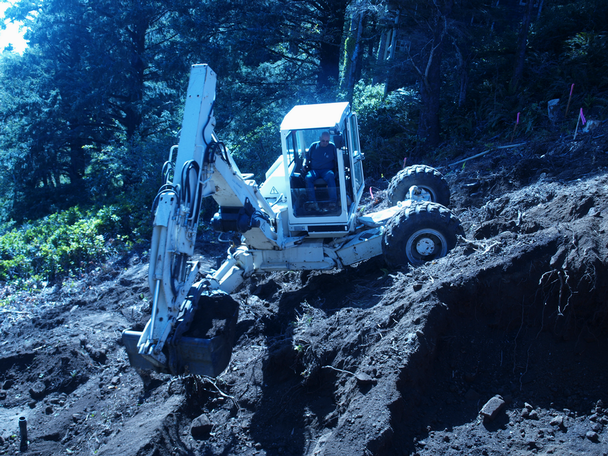

Eric on Spider Hoe Cuts Plateaus for Future Work

Rocky Moves Excavation Debris up the hill

Drilling & Installing Piers on a steep hillside requires a specialty contractor. This project utilized PLI Systems. This job proved to be a tough one, but PLI stubbornly fought down all obstacles & placed steel reinforced piers rougly 20 feet into the ground -- both vertical and horizontal shafts. Pull tests performed under the watchful eye of the geotechnical team proved the quality of their work.

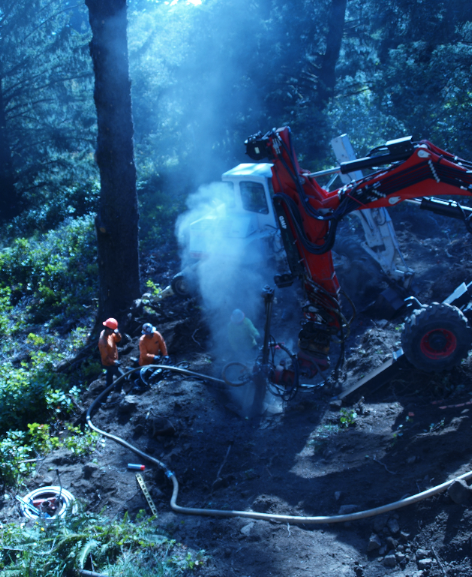

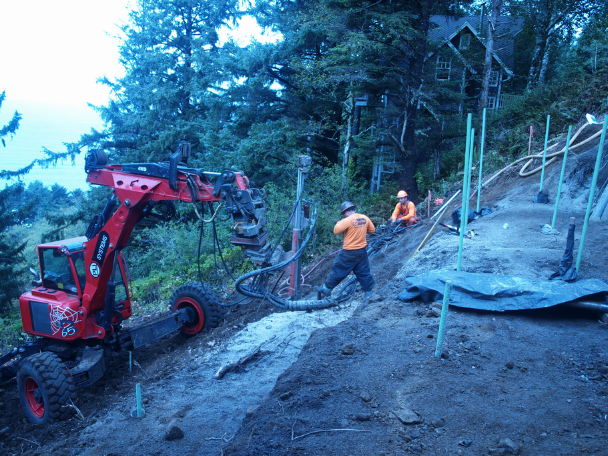

PLI Team Drills Piers into Moutain. Air Ejects Debris

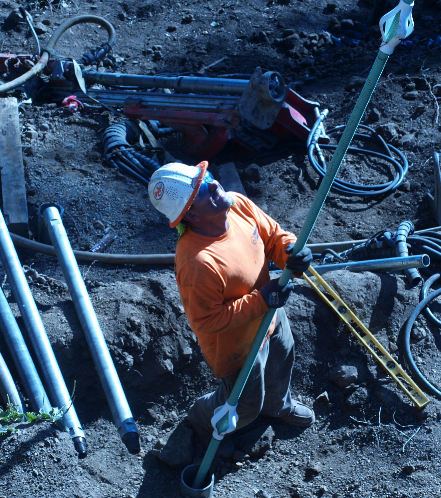

Jose Installs Steel Rods in Drilled Holes. Grout to follow.

Partially Completed Field of Drilled Piers 20 feet into mountain

Building the Foundation requires a grid of steel reinforced beams on top of the drilled piers because this is earthquake country. My "flat land" experience in Texas was helpful, but the knowledge and experience of consultant James Gardner made the job run smoothly. Good manpower is in short supply now, but with a small team we did the job!

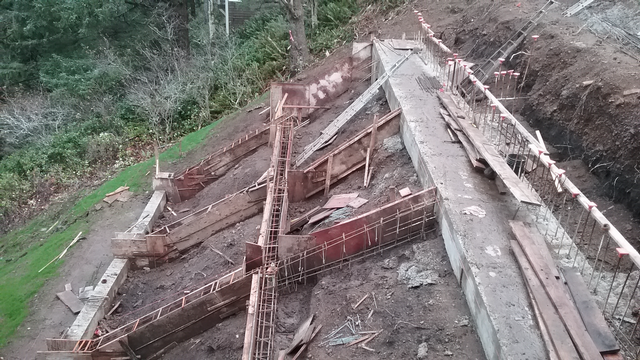

Hillside Foundation Forms by Watson Coastal Enterprises

Finally, the Foundation is Complete & Backfilled with crushed rock

Auxillary Concrete Structures: The design called for a one foot thick, 12 foot tall wall extending the length of uphill side to provide support, stiffness of the lower floor and a parking area above. The wall shown below was formed and poured by Brian Werner's wall building team. They were fast and efficient.

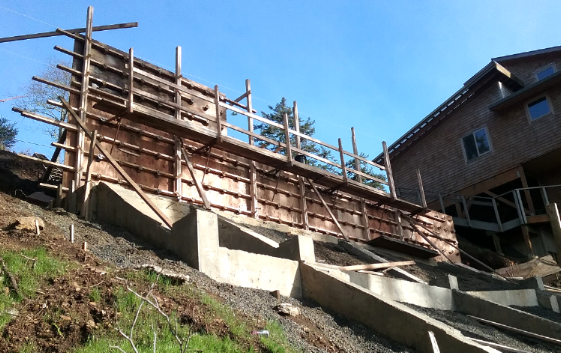

Vertical Wall by Brian Werner

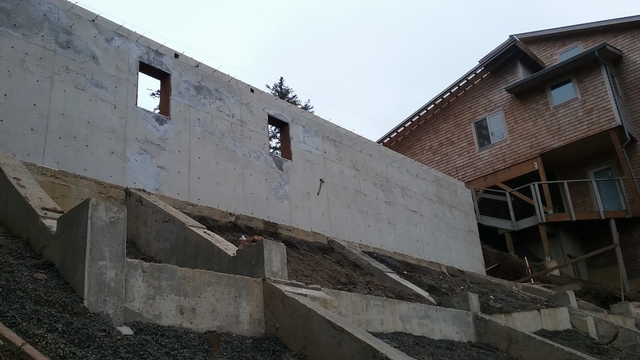

12 Foot Tall Structural Concrete Wall. New Year's Eve Status

Parking Lot Structures: The parking lot provides space for three cars to park. It consists of left and right retaining walls, that are filled with compacted stone and finally paved. This area was prepared by Watson Coastal Enterprises and Foundation Consultant James Gardner.

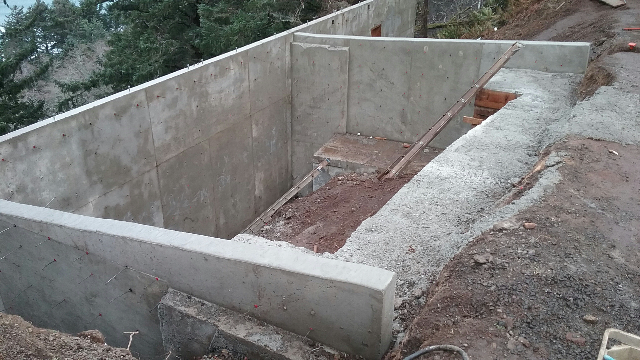

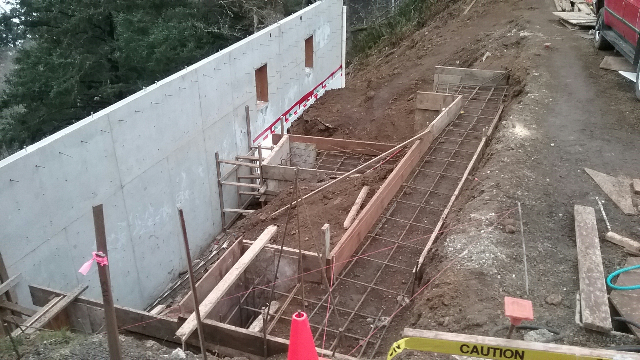

Subslabs under retaining walls

Right and left retaining walls

Weather Proofing of Underground Portions: The north wall of the building is partially underground (part of north wall on lower level abuts the parking lot). A waterproof membrane was installed by Watson Coastal Enterprises, followed by 5 inches of styro-foam insullation to subdue moisture condensation on the inside wall of the building.

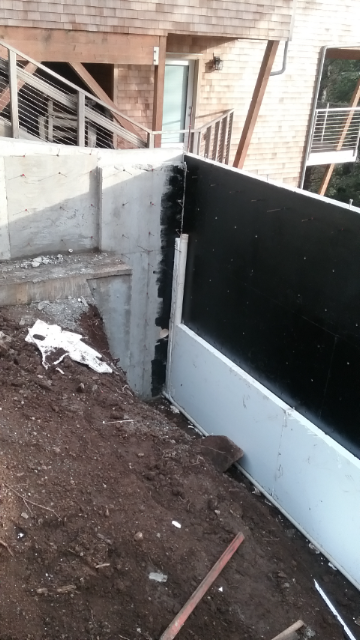

Waterproof Membrane & Insullation Partially Applied (to extend full height of wall)

Parking Lot filled with Compacted Gravel: The parking lot was next brought to grade (i.e. filled up) & a "safety fence" added to prevent unwarry on-lookers from unsafe actions. The image below gives the first clear impression of the parking lot in relation to the future building. Visitors will walk into the upper floor directly from the parking area.

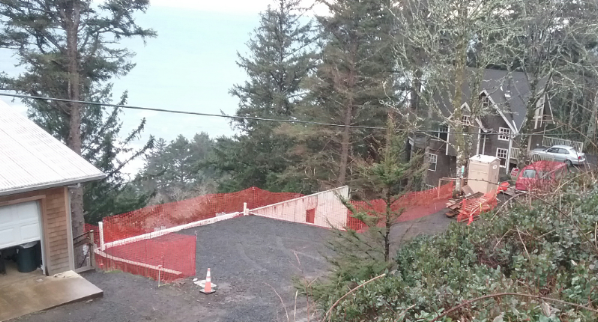

Site Plan with nearly complete parking lot & safety fences in place.

On the Back (Ocean) Side of the Wall, Columns are in Place: Watson Coastal Enterprises next installed steel columns to support the future building.

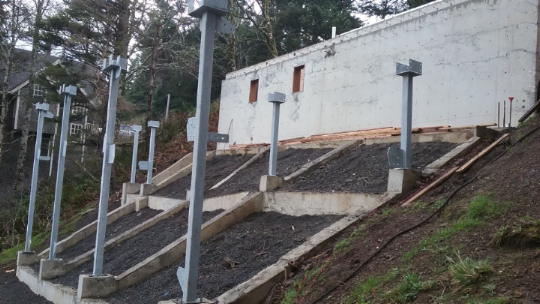

Steel Columns installed are to the ocean side of the site.

Lower Floor Support Beams: Watson Coastal Enterprises next installed large wooden beams per Engineering to support floor joists and walls of lower building floor.

Large Beams Placed on Steel Columns.

Lower Subfloor Built on Large Wooden Beams: Watson Coastal Enterprises & consultant James Gardner installed joists and plywood sub floor for down stairs of building.

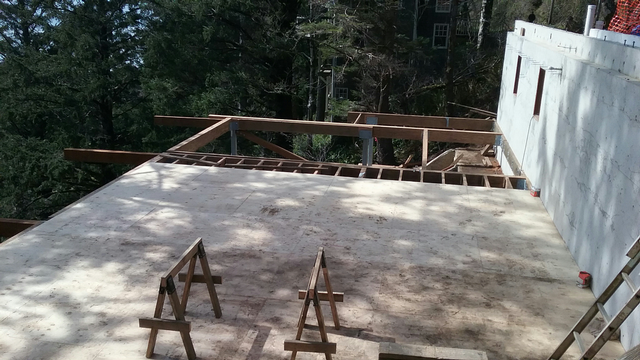

Lower Floor "Sub Floor" is Tong & Groove plywood.

April 2017: For months, building activities have been on a steep slope. With the subfloor nearing completion, the building process becomes the usual process of building on a flat surface. This subfloor is flat (as shouid be) and square (as should be). Months of foundation layout and preparation are now paying off.

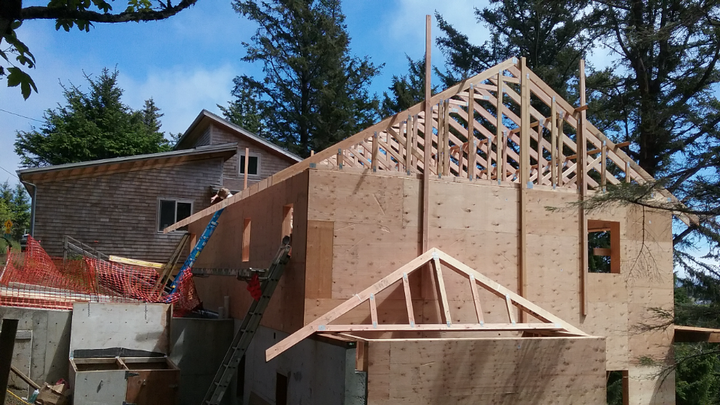

May 2017: At this time, both lower walls and upper walls have been framed. Roof trusses are in place. Most of the plywood for the roof is installed.

House structure is mostly complete. Soffits and deck in back needs work. Singles will go up in near future along with weather protection and siding. Stay Tuned!

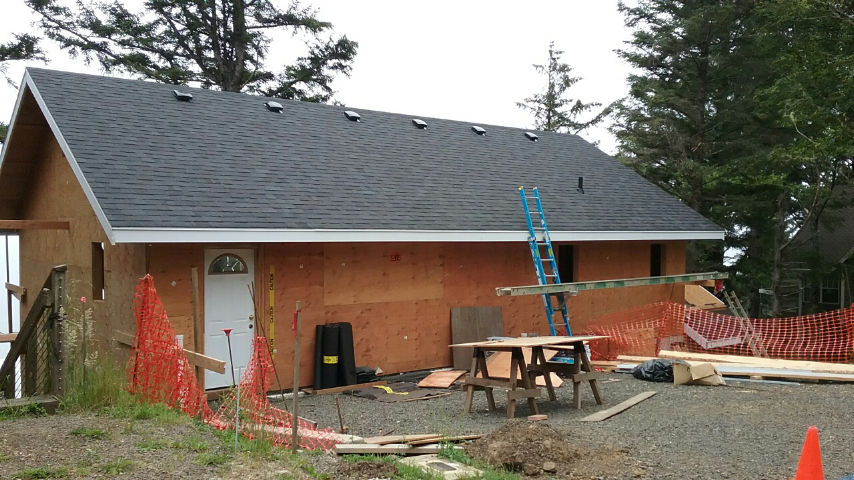

June 2017: Roof Shingles are in place. Rough plumbing complete inside the building.

Windows are on order. Door order to be placed soon along with siding. Electrical work is being planned in detail.
